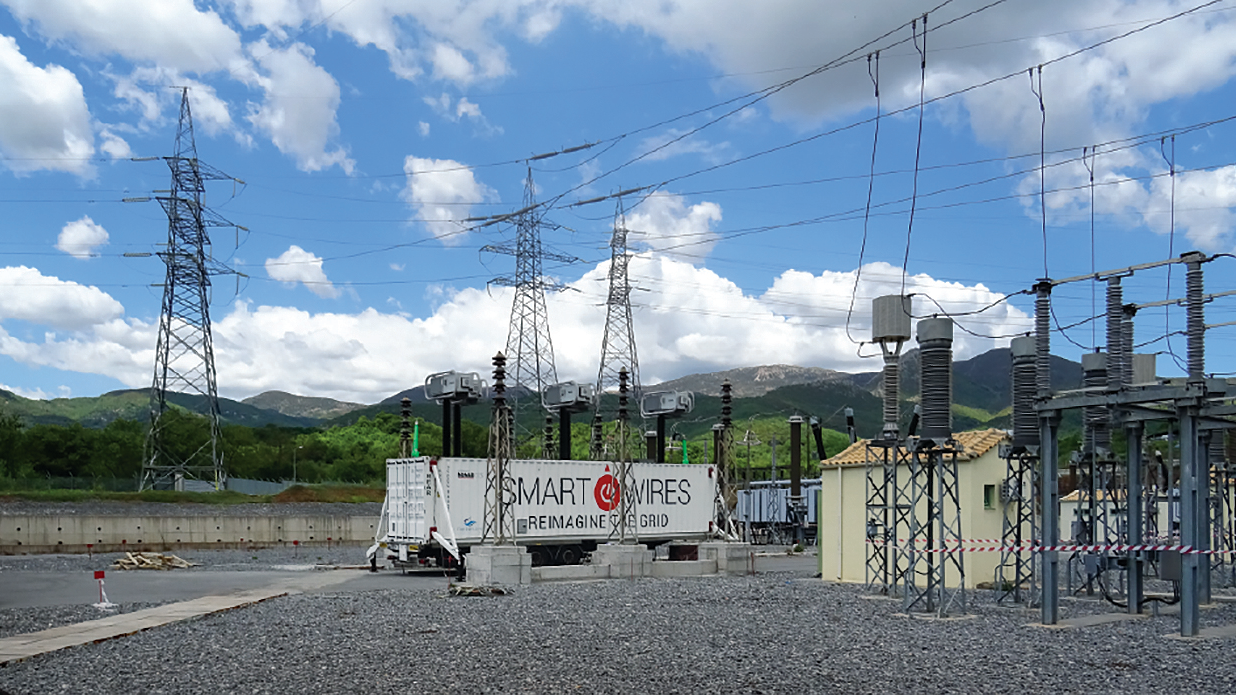

Smart Wires mobile unit installed at IPTO’s substation.

Greece Manages Congestion on the Grid

March 4, 2020
An innovative mobile power flow control solution accommodates a higher penetration of renewables.

The significant increase in renewable generation across Europe fundamentally is changing the way in which transmission system operators (TSOs) approach the design and operation of transmission systems. Independent Power Transmission Operator (IPTO), Greece’s transmission system operator, has set an enterprise goal to be one of the most efficient electricity TSOs in Europe. To achieve this goal while managing the energy transition is a complex challenge that requires innovation.

System congestion from increased levels of renewable energy is a well-known problem for TSOs worldwide. Today, the Greek Peloponnese region is served solely by a 150-kV transmission system and, because of the possible congestion issues in this area, the addition of new renewable energy projects has slowed down. More importantly, on the Greek system, the growing penetration of renewable energy in other regions could cause significant congestion elsewhere on the transmission system.

Renewable curtailment is a plausible option to alleviate congestion, but it would require system operators to dispatch expensive generation from other parts of the transmission system to meet customer demand. This action could result in increased bills for customers, higher carbon dioxide emissions and, if not resolved, depressed developer interest in future installations of renewable generation.

To enhance and accelerate the integration of renewables into the Greek power system while preventing possible curtailment of renewable generation in the future, IPTO is testing mobile modular power flow control (MPFC) technology.

MPFC technology allows TSOs to control power flow on their transmission lines. By changing the line’s impedance, power can be pushed off congested overhead lines and onto underutilized lines. This solution allows TSOs to capture the excess capacity currently available on the transmission system. Strategically installing MPFC on a transmission system can lower the investment required to accommodate a higher penetration of renewable generation and shorten the time it takes to bring renewable projects on-line.

A deployment of MPFC technology typically includes multiple devices per phase connected in series with the line. Each device operates either in injection mode or monitoring mode. In injection mode, each MPFC device injects a voltage in quadrature with the line current that modifies the line reactance. In monitoring mode, the current passes through the device but the line reactance is unaffected. The maximum injected reactance can be increased by adding more devices in series. These devices do not have the negative characteristics of passive devices such as the risk of sub-synchronous resonance (SSR) with series capacitors and the constant volt-ampere reactive (VAR) consumption of series reactors.

These devices are modular, allowing for an incremental investment strategy; quickly deployable, shortening the planning and installation cycle from years to weeks; and easily removable and redeployable, enabling transmission owners to respond to the changing needs of their grid.

Testing and Deployment

Flexible MPFC solutions dynamically control a transmission line’s impedance, effectively controlling the power flow on a given line. The degree of control can vary in accordance with the real-time needs of the grid, which can increase overall system utilization without requiring large infrastructure reinforcements.

IPTO installed the mobile MPFC technology from Smart Wires Inc. in the Peloponnese region of Greece. The installation is part of a European-funded research project called FLEXITRANSTORE, part of the European Commission’s Horizon 2020 framework.

IPTO determined where to install the mobile MPFC based on simulations using Siemens PSS/E grid planning software. After identifying a post-contingency overload, IPTO modeled the mobile MPFC on one of two 150-kV parallel single-circuit overhead transmission lines by increasing the circuit’s impedance. The results of this study indicated a deployment of mobile MPFC could reduce loading on the selected transmission line by 17%.

The mobile MPFC increases the impedance of the transmission line, effectively pushing power off that line. The thermal overload is resolved by leveraging spare capacity that exists on underutilized lines.

Following identification of the overloaded transmission line, substations on both sides of the 150-kV transmission line were evaluated to determine the optimal deployment site for the mobile MPFC solution. The substations were evaluated for installation feasibility in terms of slope, site surface materials, configuration of the overhead line conductors and overall substation configuration. Once the preferred site was chosen, the teams developed plans to connect the mobile MPFC unit to the transmission line and the substation ground grid. The site preparation work included conducting a complete site survey.

Installing the MPFC

After delivery to the substation, the following major steps were taken to install the mobile MPFC unit were as follows:

  1. Trained crew members used a power drill to deploy the trailer outriggers. The Smart Wires power flow control devices then were elevated to achieve the appropriate electrical safety clearances.
  2. The crew attached corona rings and completed the electrical connections between the devices. Steps 1 and 2 were completed with the transmission line in service.
  3. With the overhead transmission line isolated and grounded, the IPTO crew connected each phase conductor to the outer pads of the Smart Wires power flow control devices. A bucket truck was used in this procedure to install the connections to the overhead lines.

Connecting to the overhead lines required the temporary installation of poles to support the physical connections (jumpers) from the transmission line. Because of space considerations, IPTO needed to tap into the overhead transmission line mid-span, where the overhead line transitions from a vertical-stacked to a horizontal configuration at the substation gantry. These spatial and configuration challenges led the team to develop this alternative method of tapping into the overhead line while maintaining the necessary phase-to-phase electrical safety clearances.

Overall, the entire installation process took five days, one bucket truck and an eight-person field crew—four from IPTO and four from Smart Wires. The outage on the overhead line was less than 24 hours, spread across two working days. For other utilities considering deployment of this technology, site characteristics such as the slope of the site, site surface materials (bare earth, gravel or concrete), configuration of the overhead line conductors, bus bar structure and other factors impact the total installation time.

With IPTO’s assistance, Smart Wires incorporated learning benefits from this project into its technology development process, including the removal of internal lifting systems in favor of externally lifting multiple devices and insulator frames. Compared with the 2.3-MVAR unit installed at IPTO, the commercially available mobile MPFC is a 15-MVAR unit that can be installed on system voltages up to 275 kV and set up in four hours by a crew of four workers. Leveraging an on-site crane can make this process even faster. Additional mobile MPFC solutions of different values continue to be developed based on market interest.

IPTO also has gained valuable experience from the close collaborative relationship with Smart Wires throughout the site identification, feasibility and planning, installation and operational phases of the deployment.

European Showcase

By showcasing mobile MPFC technology in southeast Europe, this project is expected to be of great interest to the European Commission. The European Network of Transmission System Operators for Electricity (ENTSO-E) has indicated the main drivers for investments in this region are its high potential for solar generation combined with an existing transmission system that needs further development. This IPTO project, which relieves network congestion to enable higher renewable generation delivery, not only provides experience with mobile MPFC but also addresses some of the regional network challenges identified by ENTSO-E.

The mobile MPFC project aims to showcase the value of dynamically controlling line reactance and leveraging advanced methods for scheduling this capability in transmission planning processes. These findings are relevant for both TSOs and distribution system operators. Both systems can benefit from flexible planning and operational tools that enable better utilization of existing network capacity, as this reduces the impact of new infrastructure on communities and the environment.

IPTO is excited to gain experience with solutions like this innovative technology. Participating in the FLEXITRANSTORE project will ensure its learnings on mobile MPFC are shared broadly across Europe. IPTO aims to help cost-effectively transform the transmission system to meet the European Union’s 2050 goal of reducing greenhouse gas emissions by 80% to 95% compared to 1990 levels. MPFC is highly aligned with this long-term goal and there is great potential for MPFC to address a range of current and future challenges across European electric grids.

After IPTO gains sufficient operational experience, this mobile MPFC solution will be decommissioned from its transmission system and moved to the electricity system operator of Bulgaria. In its second location, the mobile MPFC will help to relieve another system constraint that is limiting renewable connections. Utilities also can leverage this trailer-based solution to manage short-term challenges, such as resolving transmission line overloads to enable outage windows for critical construction and maintenance works.
